Remote planning workshop facilitation: prioritizing within available capacity

Editorial illustration of Remote planning workshop · Capacity-based priorities

This guide focuses on choosing what proceeds and what waits within available capacity. The worked example follows three units: “workshop question”, “decision activity” and “agreed action”.

Reference input: workshop question and prework. Expected output: decisions converted into actions. Before assigning work, confirm the current input version and who will review the result.

Separate urgency from a genuine blockage

To prioritize the remote planning workshop facilitation, start with the consequence of inaction. A task described as urgent by preference may matter less than another that enables committed work. Compare workshop question, decision activity and agreed action using impact, dependency, useful date and effort. Avoid invented scoring weights that make an unresolved discussion appear objective. Evidence should explain why one unit should start and what is at risk if another waits. Priority is a decision about available capacity, rather than an adjective attached to every task. The decision needs to remain understandable to the people whose requests are deferred.

Calculate the capacity actually available

Before ordering requests, confirm who can work and how much time remains after other commitments and review. Theoretical availability differs from usable hours for this assignment. In this illustrative example, the team has 6 hours and three requests require 3, 2 and 4 hours. The total is 9 hours, so the complete set does not fit. That calculation requires a scope reduction, different sequence or renegotiated delivery. Assigning all three as urgent merely transfers the unresolved gap to the executor. Capacity planning becomes useful when the plan names the work that will wait.

Worked example

The fictional workshop chooses between two initiatives. Prework describes constraints and the session should produce actions. Facilitation retains the decision, executor and unresolved question so closure is more than a collection of notes.

The example involves Nora, Sofia and Valeria. Names, situations and numbers are illustrative and do not represent customer results. The three units let you test the proposed approach before extending it to other work.

UnitIllustrative effortDecision with 6 h capacityReason
workshop question3 hInclude in this cycleEnables the next commitment
decision activity2 hInclude if inputs are readyLeaves 1 h unassigned
agreed action4 hDefer and reviewThe set requires 9 h and does not fit

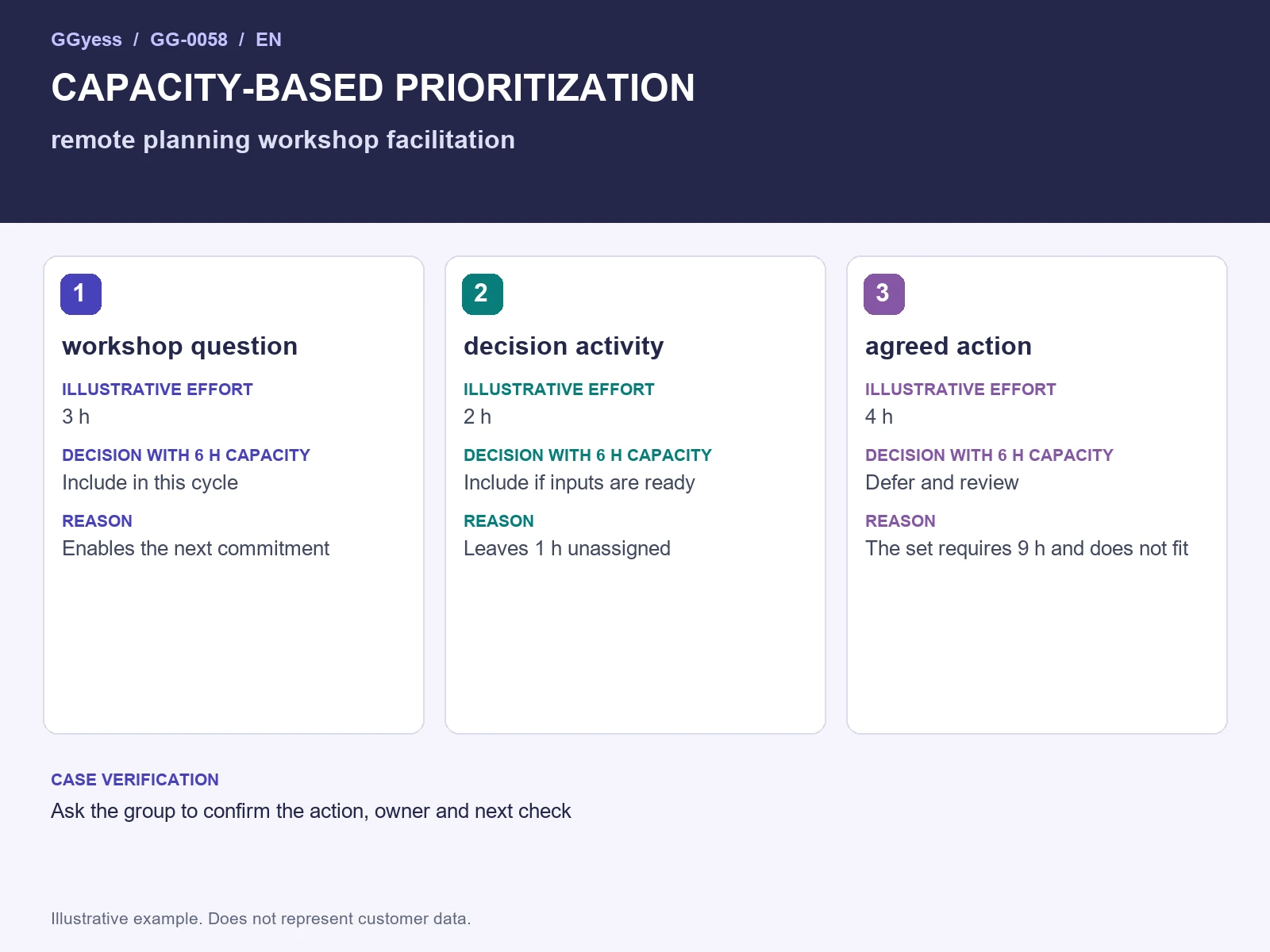

Worked-example diagram: Remote planning workshop · Capacity-based priorities
Diagram of the illustrative example. The table and text explain the complete records and their conditions.

Choose what proceeds and what is deferred

Prioritize the unit that enables the next commitment and has sufficient inputs to proceed. If another task depends on it, respect that relationship before reserving capacity. An optional improvement can wait with an explicit reason and review point. Retain the pending request so its owner understands the condition for reconsideration. In this process, control the risk of ending a workshop with extensive notes and no owned action. The proposed check is to ask the group to confirm the action, owner and next check. The order should support explaining a difficult decision through observable facts, including the value that will remain unrealized because another delivery was selected first.

Revisit the order when evidence changes

The initial order becomes less useful when a dependency, date or availability changes. Define the signal that triggers reconsideration and who can decide. Keep the goal of producing decisions converted into actions, using workshop question and prework as the reference. When a new urgent request appears, show which work it would displace before accepting it. Record the previous commitment, new decision and affected recipients. This allows adaptation without turning every message into an informal reassignment that nobody reflects in the plan, leaving several apparently prioritized tasks without the capacity needed to complete them.

What to check before closure

The risk to control in this case is ending a workshop with extensive notes and no owned action. A completed label needs a supporting observation. Keep the following beside the decision so the receiver can establish what was checked:

  • Input and version used: workshop question and prework.
  • Case check: ask the group to confirm the action, owner and next check.
  • Outcome under review: decisions converted into actions.

Your privacy on this blog

Choose our own statistics, Google Analytics, Cloudflare, and Google Signals with personalized advertising. The last option allows audiences for GGyess ads and combines your activity with Google data; it also requires permission for Google Analytics. Accept all allows the available options, including advertising when available; it does not subscribe you to the newsletter. Necessary only rejects every option. Permissions last up to 180 days; we remember advertising refusals for 12 months.

Necessary preferences

Remember your language, display theme and privacy choice. These preferences are not used to measure your reading.

Privacy notice · Privacy requests: myprivacy@gloadi.com
